Fast-Track Power for a Hyperscale Data Center Hall

A hyperscale operator needed redundant transformer capacity for a new compute hall months ahead of standard OEM lead times. JCL pulled matching units from stock and ran phased delivery against the construction schedule.

Fast-Track Power for a Hyperscale Data Center Hall
Client
Hyperscale data center operator
Location
Central United States
Capacity
8 × 3000 kVA
Voltage Class
34.5 kV
Case Study · Data Centers

Fast-Track Power for a Hyperscale Data Center Hall

When a hyperscale operator broke ground on a new compute hall, the power equipment timeline was the long pole. Standard OEM lead times would have pushed energization past the go-live date. JCL Energy delivered redundant transformer capacity on the construction schedule — not the factory's.

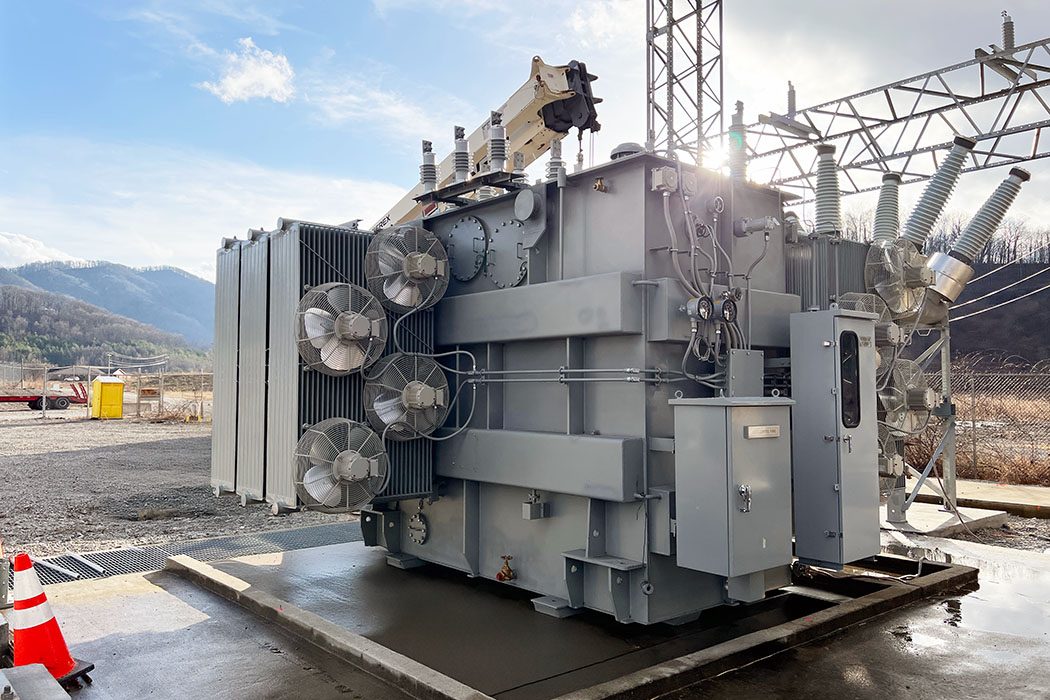

Custom substation transformer staged for a data center deployment
Engineered substation transformer ready for shipment
The Challenge

Compute capacity was waiting on copper and steel

The operator had committed go-live dates to its tenants, but the new hall needed eight 3000 kVA units in an N+1 redundancy topology — and the OEMs they’d normally use were quoting 40-plus week lead times. Every week of slip pushed millions in deferred revenue and risked breaching tenant SLAs.

The units also had to match the campus standard: 34.5 kV primary, specific impedance and tap arrangements, and full factory acceptance testing so the commissioning team could energize without surprises in the field.

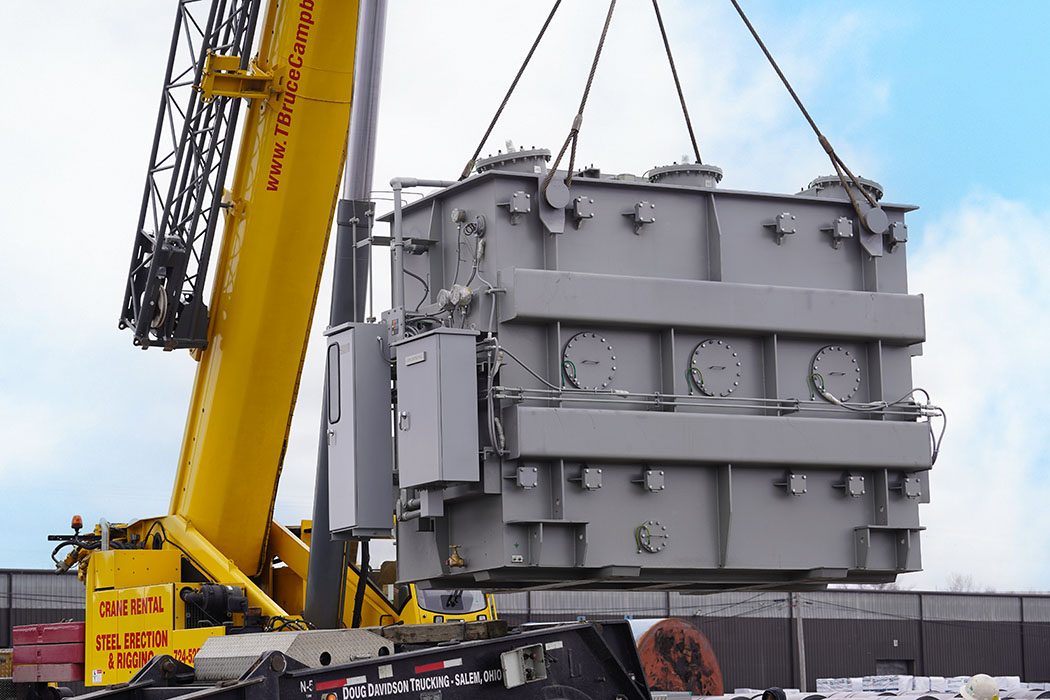

Substation transformers staged for phased delivery
The Solution

Stocked units, spec-matched, on a phased schedule

JCL identified six matching units from existing stock and sourced the remaining two through our supplier network with expedited build slots. Our engineers reviewed the campus spec against each unit’s nameplate, impedance, and tap configuration before anything shipped — so the operator’s commissioning team got exactly what they specified.

Rather than dropping all eight units on a muddy construction site at once, we ran a phased delivery aligned to the build sequence: the first redundant pair landed as the pad cured, with the balance arriving as each section came online. Every unit shipped with complete factory acceptance test reports and nameplate verification.

8
Units delivered
16wk
Ahead of standard lead time
N+1
Redundancy achieved
0
Field rework on energization
